This project enhances learning spaces through thoughtful design, efficient planning, and coordinated construction for improved education.

Initial Process

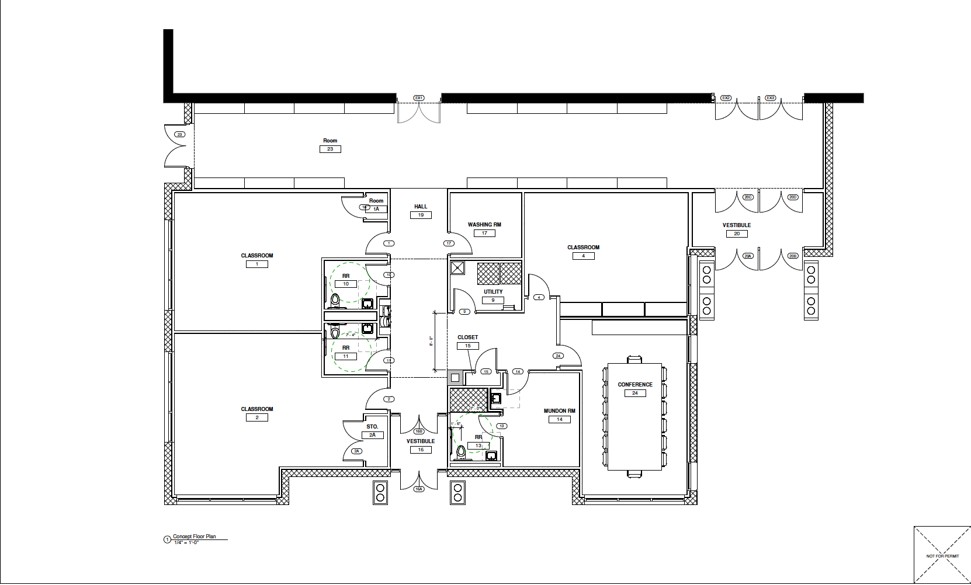

  • All design and exterior drawings were finalized earlier this year.
  • Final construction documents have been submitted to the City for review.
  • Phased permit applied, foundation permit received.

Bid Process

  • We received five bids from General Contractors after releasing the permit drawings.
  • Three arrived by the deadline, while two were submitted late.
  • The bids ranged from $1.4 million to $1.7 million, higher than initial estimates.
  • Current political conditions, labor market constraints, and inflation were major contributing factors.

Downselect Process

  • The HTCC committee carefully reviewed and compared each bid, incorporating value engineering to ensure cost-effectiveness and maintain project standards.
  • After thorough evaluation of qualifications, pricing, and project needs, one contractor selected.
    • Complete Construction Services
  • The construction contract officially gets signed on November 11, 2025

Project Timeline

The pace of this project reflects both purpose and inclusiveness

  • Each milestone was shaped through collaboration
  • Community voices guided every decision
  • Thoughtful planning ensured steady, transparent progress

Here is the timeline:

Key Activities Date
Final drawings completed by August 18, 2025
General contractor bids due September 26, 2025
General contractor selection finalized by October 23, 2025
Notice to proceed issued November 11, 2025
Groundbreaking scheduled for November 29, 2025
Construction completed by Sep 3, 2026
